Minooka Data Center WatchMinooka & Surrounding Area — Public Resource

Equinix Data Center — Minooka Campus

Wildy Road & Ridge Road area, Minooka, IL

Approved

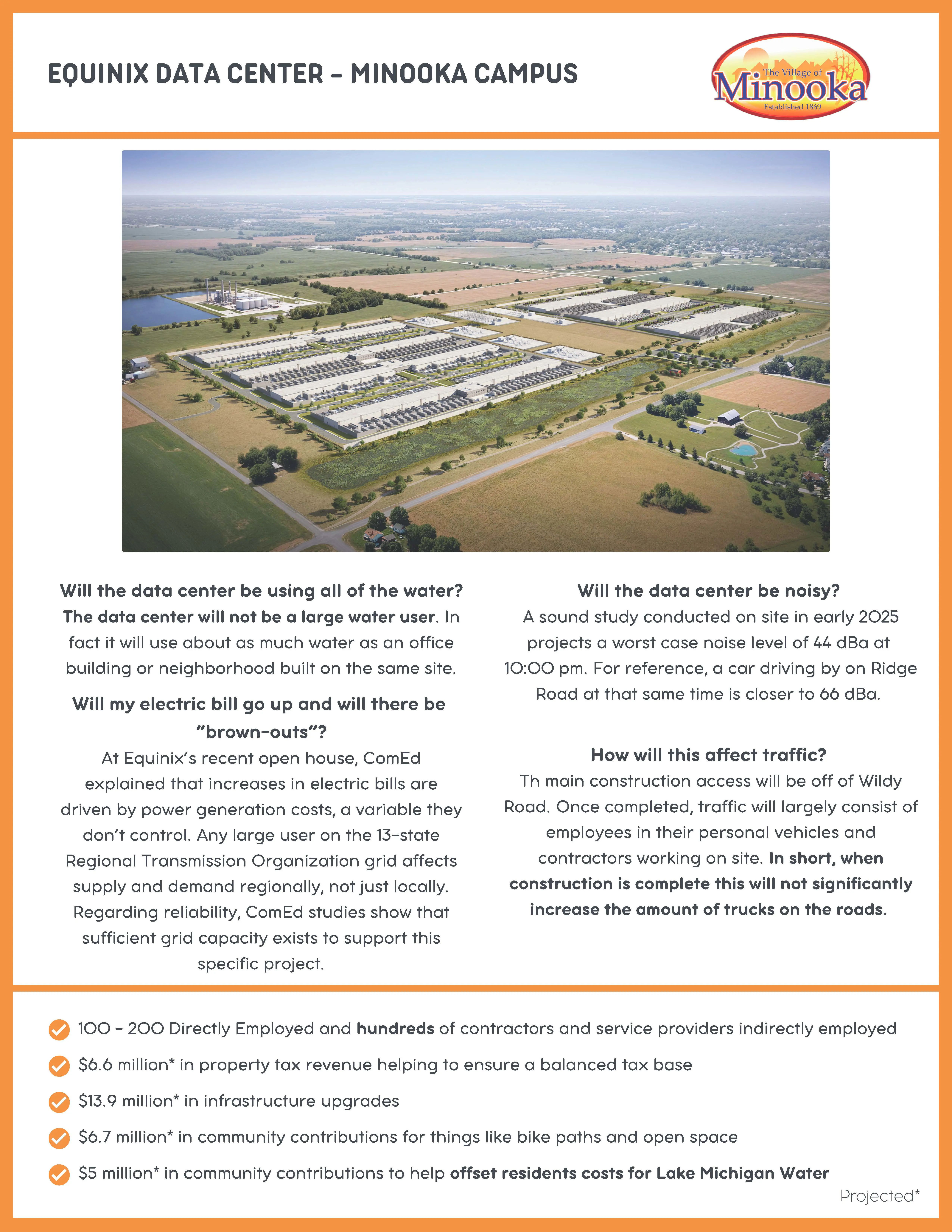

Summary

Equinix is constructing a large data center campus in Minooka, Illinois, spanning approximately 368 acres of assembled land. The project — 4 hyperscale buildings and 3 colocation/retail data centers — was formally approved by the Village of Minooka on September 23, 2025 via annexation, rezoning, and PUD ordinances.

The Village projects $5.9–$7.4 million in annual property tax revenue and approximately 140 direct jobs (20 per building) upon completion, plus $13.9 million in projected infrastructure upgrades.

Equinix is a 27-year-old company operating 270 data centers across 75 major metro areas worldwide, with more than 5 facilities already in Illinois.

Key Facts

Direct Jobs

~140 employees (20 per building across 7 buildings) + contractors/service providers

Property Tax Revenue

$5.9–$7.4 million projected annually (per Village Board, Sept. 2025)

Infrastructure Upgrades

$13.9 million* projected

Community Contributions (parks & paths)

$6.7 million* projected

Lake Michigan Water Cost Offset

$5 million* projected

Total Building Area

1.1 million sq ft across 7 buildings (per Baxtel industry profile)

Cooling Design

Air-cooled closed-loop — water-intensive cooling was rejected by the Village

Construction & Operations Timeline

Site prep: 2026 | Construction: 2027 | First operations: 2031 | Full build-out: ~10-year phased plan

* Projected figures from Village of Minooka fact sheet.

Timeline of Events

  1. March 27, 2026

    Village Board approves final plat and easements; site preparation begins

    Minooka Village Board / Equinix

    Board approves final plat and easements. Equinix will pay approximately $13 million for water, sewer, and road infrastructure. Site prep begins at the northwest corner of Ridge and Walde roads, with a 600-foot landscaped setback and sound barrier. Build-out follows a phased 10-year plan: first 3–4 AI buildings, then a large substation, then the remaining structures.

  2. December 16, 2025

    Community opposition petition launched on Change.org

    Carli Ann (Change.org)

    Petition cites concerns about water and energy consumption, traffic, noise, infrastructure strain, and property values. Calls for thorough environmental impact assessments before construction proceeds. Reached 567 signatures as of mid-2026.

  3. October 15, 2025

    Community-facing fact sheet published addressing resident questions

    Josh Stell — stellforminooka.com

    Pro-project analysis addresses common resident questions: electricity costs are shared across the 13-state PJM regional grid; the village rejected water-intensive cooling and required air-cooling instead; engineering studies confirm adequate grid capacity. Author notes $25 million in infrastructure investments benefit residents without raising local taxes.

  4. September 30, 2025

    Community open house held

    Equinix / Village of Minooka

    Over 100 residents attended. ComEd's Bill Pegel addressed electricity and grid reliability questions. Village Administrator Dan Duffy projected ~$7 million in taxes over ten years. Construction scheduled to begin 2027, operations 2031.

  5. September 23, 2025

    Public hearing and board approval — 6 Equinix ordinances passed

    Minooka Village Board

    Village Board approved Ordinances 2025-24 through 2025-29: Annexation & Development Agreement, Annexation of territory, Rezoning to DC Data Center District, Conditional PUD Permit, Data Center Design Guidelines correction, and Zoning Ordinance amendment. Agreement not effective until Equinix closes on the property. Final plat and Letter of Credit still required.

  6. March 2025

    Project draws first major media coverage

    Chicago Tribune

    Tribune investigation covers the Minooka proposal as part of a broader look at Illinois's data center building boom. Initial proposal details reported: approximately 340 acres, up to 700 megawatts of electricity, and 3 million gallons of water per day. Coverage features local farming families and raises questions about underground aquifer impacts and Illinois's 2035 carbon-free energy goals.

  7. Early 2025

    On-site sound study completed

    Equinix

    Worst-case noise projected at 44 dBA at 10:00 pm — quieter than a passing car on Ridge Road (66 dBa)

Community Questions & Answers

Will the data center be using all of the water?

The data center will not be a large water user. In fact it will use about as much water as an office building or neighborhood built on the same site.

Will my electric bill go up and will there be 'brown-outs'?

At Equinix's recent open house, ComEd explained that increases in electric bills are driven by power generation costs, a variable they don't control. Any large user on the 13-state Regional Transmission Organization grid affects supply and demand regionally, not just locally. ComEd studies show that sufficient grid capacity exists to support this specific project. A ComEd representative also attended the September 23, 2025 Village Board public hearing and confirmed: 'This has no bearing on distribution. There will be no shortage of power.'

Will the data center be noisy?

A sound study conducted on site in early 2025 projects a worst case noise level of 44 dBA at 10:00 pm. For reference, a car driving by on Ridge Road at that same time is closer to 66 dBa.

How will this affect traffic?

The main construction access will be off Wildy Road. Once completed, traffic will largely consist of employees in their personal vehicles and contractors working on site. In short, when construction is complete this will not significantly increase the amount of trucks on the roads.

What happened to the 3 million gallons of water per day mentioned in early news reports?

That figure came from Equinix's original proposal. The Village of Minooka rejected water-intensive cooling and required an air-cooled closed-loop design instead. The approved campus uses air cooling to minimize water use — a condition built into the development agreement.

When will construction begin and when will the campus be operational?

At the September 30, 2025 community open house, the Village projected construction starting in 2027 and operations beginning in 2031. Site preparation work began in early 2026 at the northwest corner of Ridge and Walde roads. Equinix's build-out is a phased 10-year plan: the first 3–4 AI buildings go up first, then a large substation, then the remaining structures.

Is there organized opposition to the project?

Yes. A community petition on Change.org was launched December 16, 2025, citing concerns about water and energy consumption, traffic, noise, infrastructure strain, and property values. It calls for thorough environmental impact assessments and reached 567 signatures as of mid-2026. The Village Board had already approved the project on September 23, 2025, prior to the petition being filed.

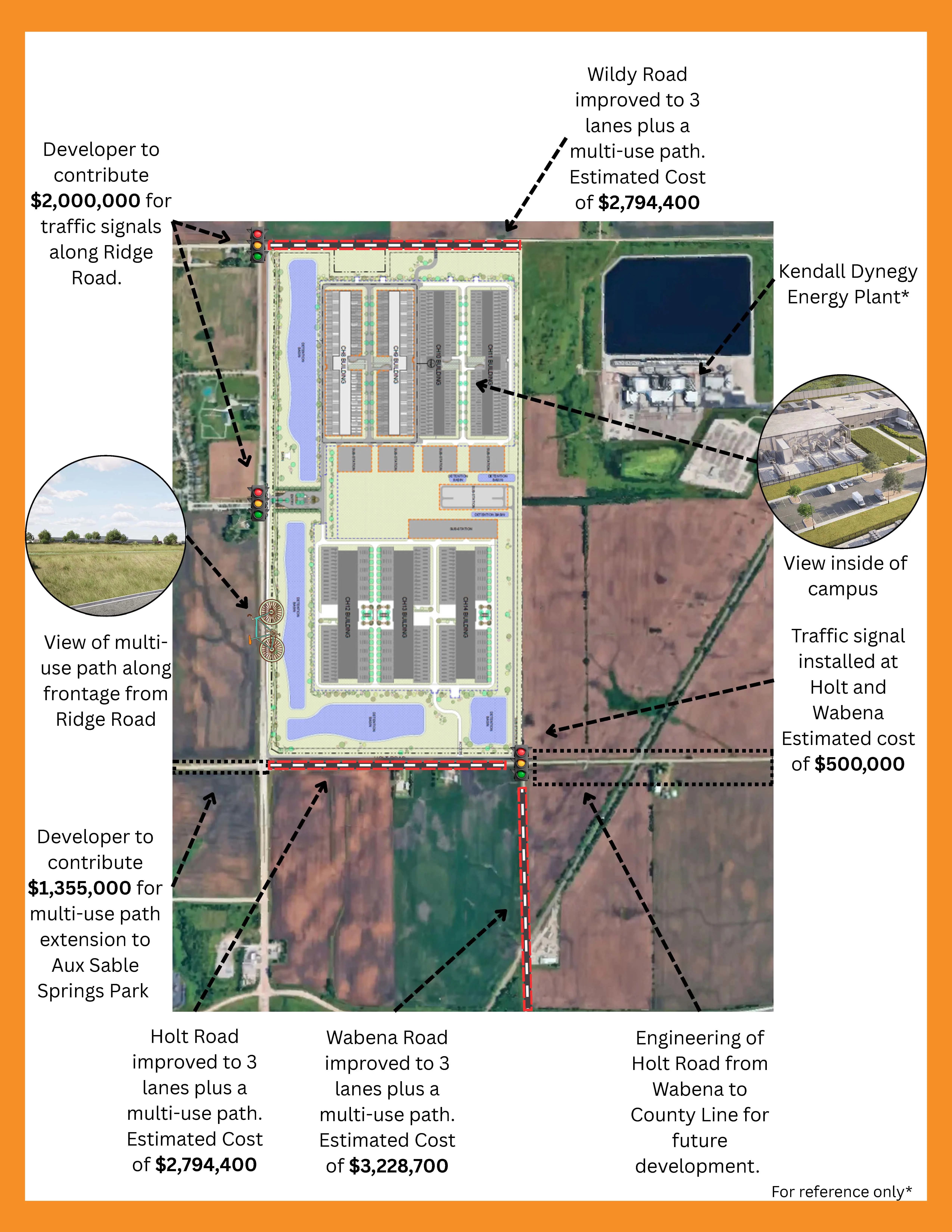

Infrastructure Contributions

ImprovementAmountBy
Traffic signals along Ridge Road$2,000,000Developer
Multi-use path extension to Aux Sable Springs Park$1,355,000Developer
Traffic signal at Holt & Wabena intersection$500,000 estimatedDeveloper
Wildy Road — widened to 3 lanes plus multi-use path$2,794,400 estimatedDeveloper
Holt Road — widened to 3 lanes plus multi-use path$2,794,400 estimatedDeveloper
Wabena Road — widened to 3 lanes plus multi-use path$3,228,700 estimatedDeveloper
Engineering of Holt Road (Wabena to County Line) for future developmentTBDDeveloper
Intersection of Holt & Wildy — significant improvementTBDDeveloper

How Officials Voted

OfficialTitleVoteDateMeeting
Ric OffermanVillage PresidentYesSeptember 23, 2025Ord. 2025-24 — Annexation & Development Agreement (Equinix)
Barry ThompsonTrusteeYesSeptember 23, 2025Ord. 2025-24 — Annexation & Development Agreement (Equinix)
Ray MasonTrusteeYesSeptember 23, 2025Ord. 2025-24 — Annexation & Development Agreement (Equinix)
Dennis MartinTrusteeYesSeptember 23, 2025Ord. 2025-24 — Annexation & Development Agreement (Equinix)
Robin WhiteTrusteeYesSeptember 23, 2025Ord. 2025-24 — Annexation & Development Agreement (Equinix)
Gabriela MartinezTrusteeYesSeptember 23, 2025Ord. 2025-24 — Annexation & Development Agreement (Equinix)
StellTrusteeAbsentSeptember 23, 2025Ord. 2025-24 — Annexation & Development Agreement (Equinix)
Barry ThompsonTrusteeYesSeptember 23, 2025Ord. 2025-25 — Annexation of Territory (Equinix)
Ray MasonTrusteeYesSeptember 23, 2025Ord. 2025-25 — Annexation of Territory (Equinix)
Dennis MartinTrusteeYesSeptember 23, 2025Ord. 2025-25 — Annexation of Territory (Equinix)
Robin WhiteTrusteeYesSeptember 23, 2025Ord. 2025-25 — Annexation of Territory (Equinix)
Gabriela MartinezTrusteeYesSeptember 23, 2025Ord. 2025-25 — Annexation of Territory (Equinix)
StellTrusteeAbsentSeptember 23, 2025Ord. 2025-25 — Annexation of Territory (Equinix)
Barry ThompsonTrusteeYesSeptember 23, 2025Ord. 2025-26 — Rezoning to DC Data Center District
Ray MasonTrusteeYesSeptember 23, 2025Ord. 2025-26 — Rezoning to DC Data Center District
Dennis MartinTrusteeYesSeptember 23, 2025Ord. 2025-26 — Rezoning to DC Data Center District
Robin WhiteTrusteeYesSeptember 23, 2025Ord. 2025-26 — Rezoning to DC Data Center District
Gabriela MartinezTrusteeYesSeptember 23, 2025Ord. 2025-26 — Rezoning to DC Data Center District
StellTrusteeAbsentSeptember 23, 2025Ord. 2025-26 — Rezoning to DC Data Center District
Barry ThompsonTrusteeYesSeptember 23, 2025Ord. 2025-27 — Conditional PUD Permit (Equinix)
Ray MasonTrusteeYesSeptember 23, 2025Ord. 2025-27 — Conditional PUD Permit (Equinix)
Dennis MartinTrusteeYesSeptember 23, 2025Ord. 2025-27 — Conditional PUD Permit (Equinix)
Robin WhiteTrusteeYesSeptember 23, 2025Ord. 2025-27 — Conditional PUD Permit (Equinix)
Gabriela MartinezTrusteeYesSeptember 23, 2025Ord. 2025-27 — Conditional PUD Permit (Equinix)
StellTrusteeAbsentSeptember 23, 2025Ord. 2025-27 — Conditional PUD Permit (Equinix)

Incentive Agreements

Property TaxApproved: 2025

$6.6 million* projected in annual property tax revenue helping to ensure a balanced tax base

Approved by: Village of Minooka

Community ContributionsApproved: 2025

$6.7 million* for bike paths and open space; $5 million* to offset residents' Lake Michigan Water costs

Approved by: Village of Minooka

Documents Library

DocumentTypeDateSourceLink
Equinix Data Center – Minooka Campus Quick Fact SheetFAQ / Fact Sheet2025Village of MinookaView →
